|
          With the Observatory building on order from
         Astronomydome, I made a start on the base on 31st. March
         2004. The obvious place for the Observatory was within an
         existing circle of shrubs towards the West of the garden.
         There were already a number of substantial stone slabs in
         the ground , well settled after many years - a good
         foundation for the bulk of the 'walk on' slab.
       |


       |


      |

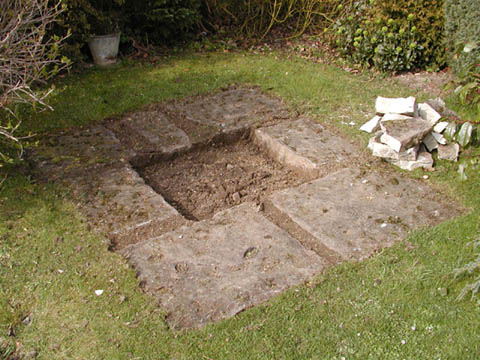

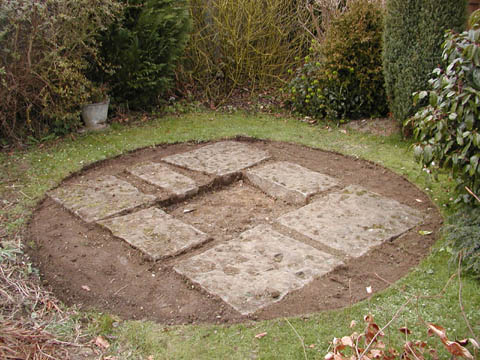

          Once the overgrown turf was cleared away the centre slab
         was larger than it first seemed, and was VERY heavy! But
         judicious application of the heel of a large axe in lieu of
         a sledgehammer soon broke up the 4" thick sandstone lump
         into manageable pieces. (I later got some flak for that from
         a friend who would have given her eyeteeth for the slab.
         With hindsight, perhaps I should have lifted and saved all
         the slabs. But they did make a very good foundation!) The

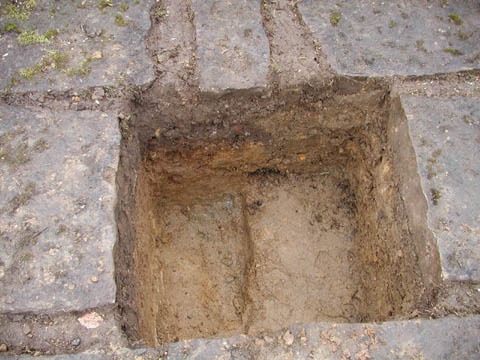

         perimeter of the hole is now approximately 30" x 36" - a
         good size for the block, I just need to go down a bit!
       |


       |


      |
          The 8 ft. Observatory dome comes with precast perimeter
         blocks and requires an 8' 6" base. So I'm making a 9' base
         to give support round the edges.
       |


       |


      |

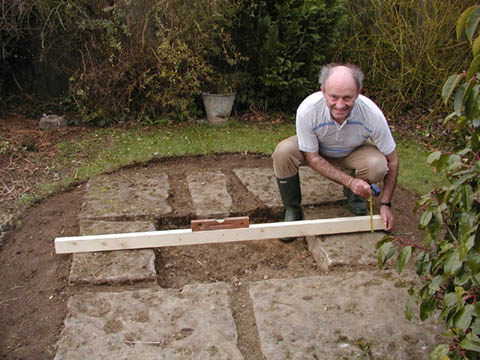

          Finally a check on the levels before I start digging!
         Apart from a bit of a fall away to the South, the area is
         level within about half an inch. I intend to cast the pier
         block about 3" above the lip of the stone slabs, with the
         circular slab to follow at the same level.
       |


       |


      |
          After some hard labour...... A gravel incursion in one
         corner - possibly an old soakaway. So I didn't go any deeper
         there, but stepped the hole down a bit further at the other
         (South ) end. The finished block will be about 32" (0.8 m)
         deep at the stepped end, and will weigh approximately 1200
         Kg. I think I'll hire a cement mixer!
       |


       |


      |
          Now I was ready to start on the really hard bit! Easter
         weekend was approaching, and the local builder's merchant
         had a special offer on - three days equipment hire for the
         price of one. Too good to miss! So on Easter Saturday I set

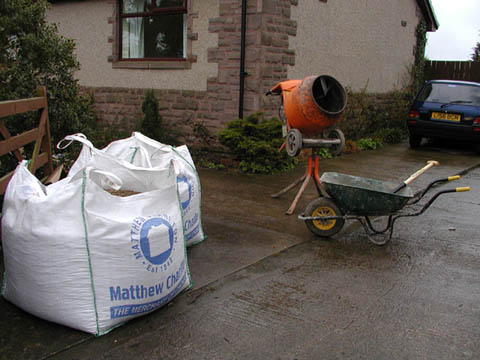

         up the hired mixer and barrow, next to the previously
         delivered 'dumpy' bags of mixed sand and gravel .
       |


       |


      |

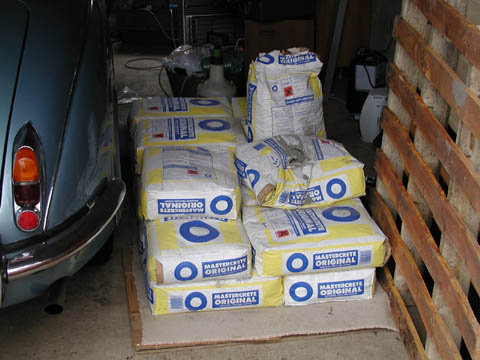

          And of course the cement needs to be kept dry. My old
         Daimler wasn't too impressed! By the end of the job it
         needed a wash!!
       |


       |


      |

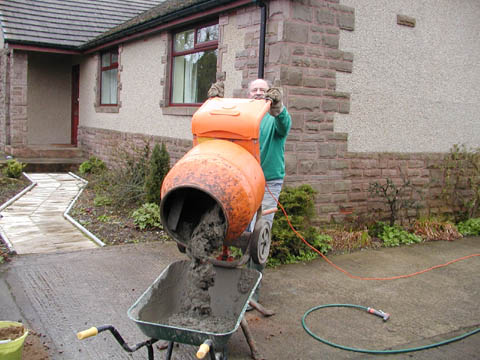

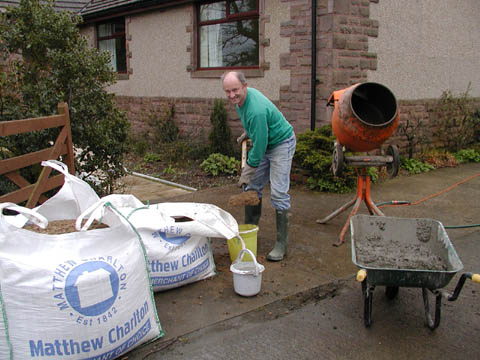

          So off we jolly well go! Two large buckets of sand and
         gravel to one small one of cement was about right. And start
         the next mix off before pouring the previous one - with only
         myself working, I had to make the best use of my time!
       |


       |


      |
          Into the barrow.
       |


       |


      |

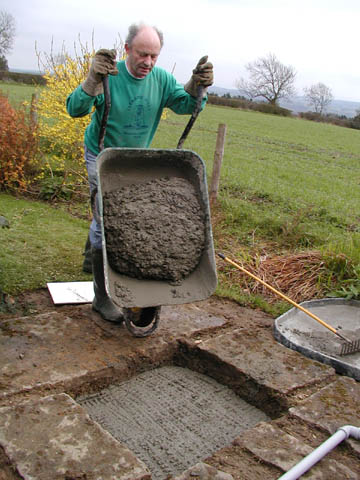

          And into the hole. Nearly full now!
       |


       |


      |

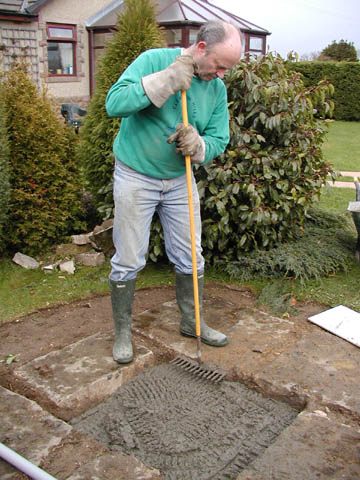

          Tamp it down.
       |


       |


      |
          And smooth it off when full to the brim. The excess of
         the last mix filled in some of the South side fall away.

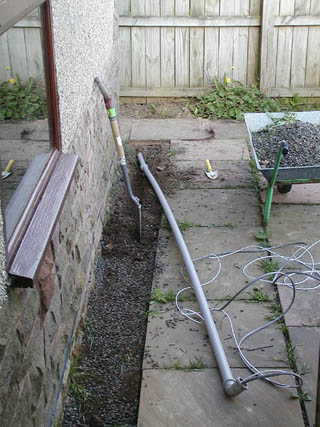

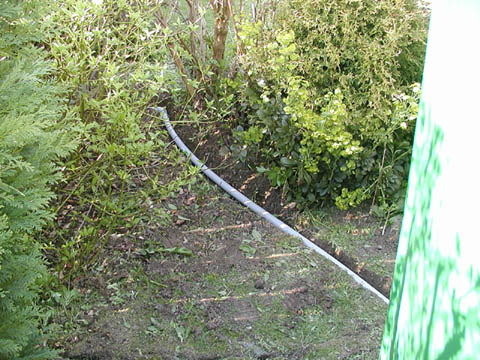

         Don't forget the pipes to run wiring into the Observatory
         and through the slab to the pier!
       |


       |


      |
          Leave the block to set for a day (Easter Sunday) then

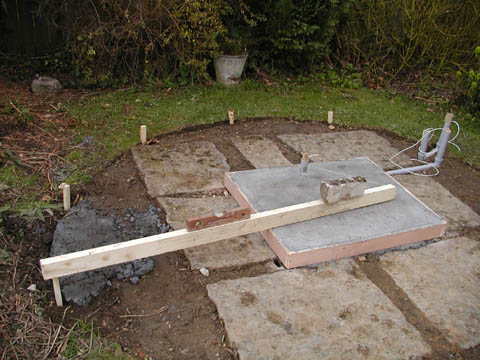

         start again on the Monday. A new meaning to the term 'level
         pegging'! I left the blockboard around the centre to help
         minimise vibration transmitted from the surrounding
         slab.
       |


       |


      |
          Because of restricted access I had to leave part of the
         outer formwork off to get to the rear of the slab.
       |


       |


      |

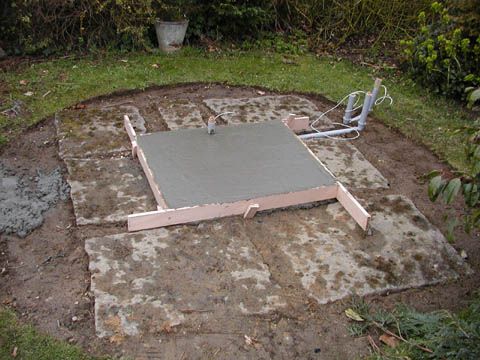

          But eventually the work progressed far enough for the

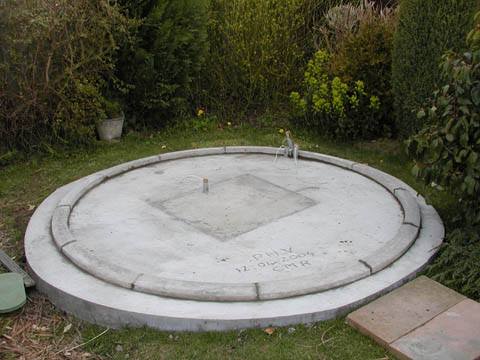

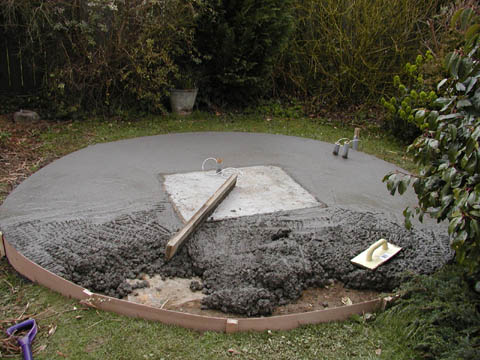

         (almost perfect!) circle to be completed. The ground is well
         drained and stable, and the slab is over 6" at its thickest,
         with support from the existing stone slabs at the 3"
         thinnest parts, so I didn't feel there was any need for
         reinforcement.

         (Fifteen years later there's no sign of movement or
         cracking.)
       |


       |


      |

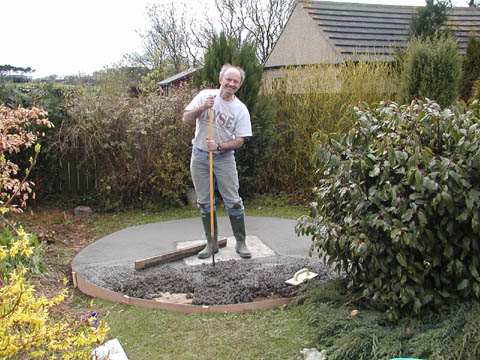

          Still Tamping!
       |


       |


      |

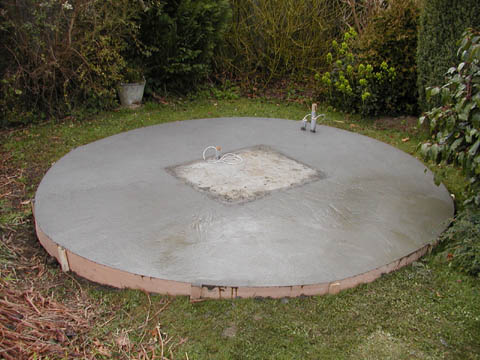

          At last the slab was complete. A brief shower puddled on
         the surface, but that was soon removed.
       |


       |


      |
          And I enjoyed a well earned G & T!
       |


       |


      |

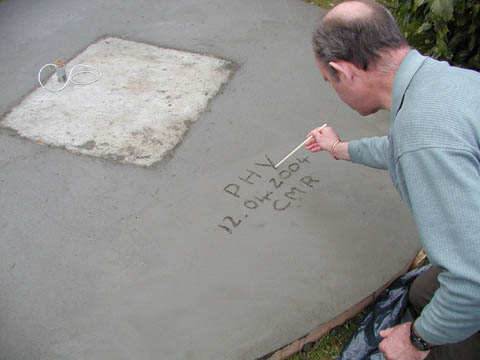

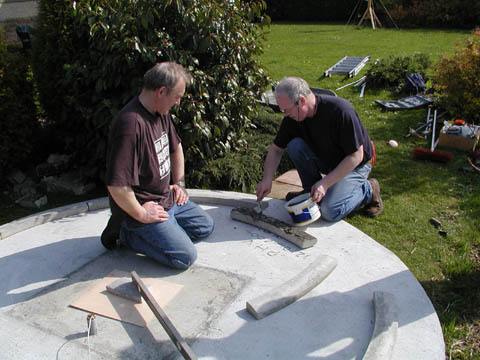

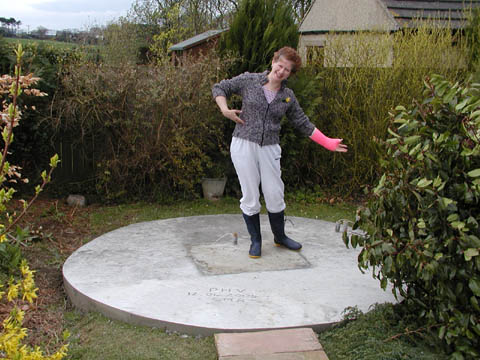

          Add the final touches! I'm PHV, CMR was behind the
         camera, and provided support and sustenance. She couldn't
         safely step over to the centre, so had to wait until the
         slab had cured - see later. That's 12th. April of course -
         English date convention!
       |


       |


      |

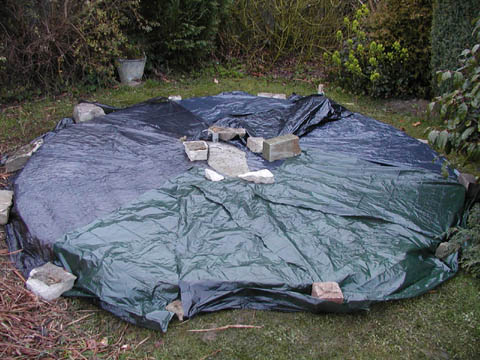

          Now leave it to cure for a couple of days!! I was very
         fortunate with the weather. After many days of wind and
         rain, I had three consecutive days of cool, calm conditions
         with only a couple of light showers while I was working.
       |


       |


      |
          Here as promised - CMR! The pink monstrosity attached to
         Carolyn's left arm is a 'Short Arm Thumb Cast' She allegedly
         detached a thumb ligament and sustained a hairline fracture
         of her right fibula while skiing in March. I reckon it was
         just a ploy to get out of digging and laying concrete! That
         was why she couldn't safely step over to the middle block
         while the pad was still soft.

         Actually the injuries were rotten luck - her first skiing
         holiday and she had a bad fall less than half way through
         it. But many thanks for the innumerable cups of tea, coffee,
         and sandwiches which kept me going.
       |


       |


      |
          So with the base ready, all I needed was the Dome! And it
         duly arrived on 24th. April, complete with erection team.

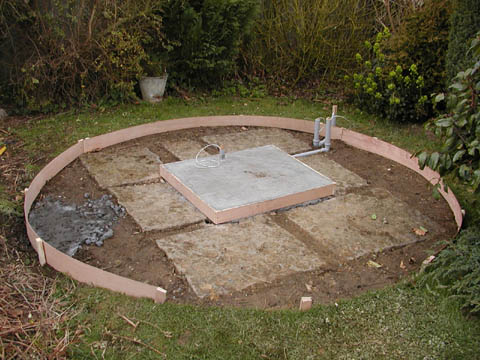

         First job - install the base ring with quick setting
         cement.
       |


       |


      |
          Done!
       |


       |


      |

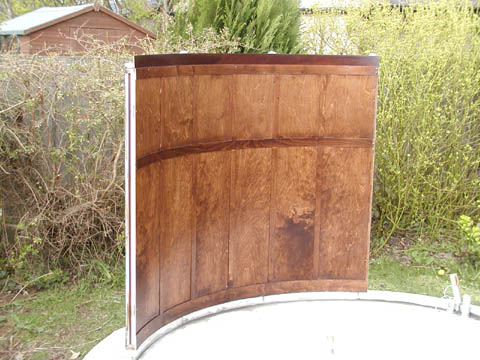

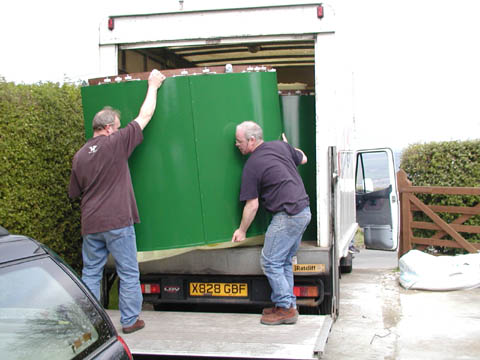

          The dome parts were built in a workshop in sections,
         completely assembled to check the fit, then disassembled for
         transport.
       |


       |


      |
          And here's the first section on the base.
       |


       |


      |

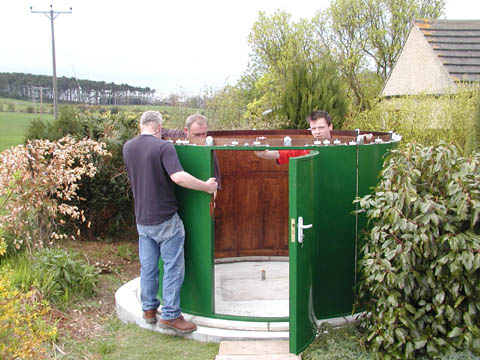

          All the parts fit together beautifully! John (don't be
         shy!), Graham and John's son Alex. What a team!
       |


       |


      |
          The side sections were then pulled tightly together,
         bottom first, then top as here, and the fixing plates
         screwed on.
       |


       |


      |

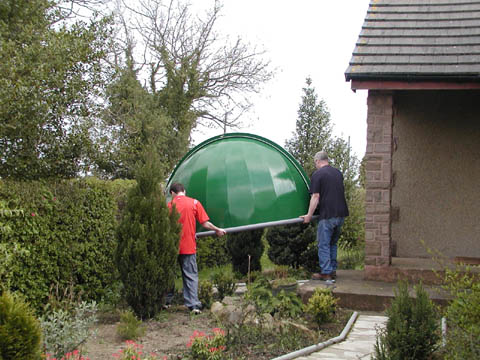

          All the larger components had to be carried round the end
         of the house. The dome halves needed the full team! Note the

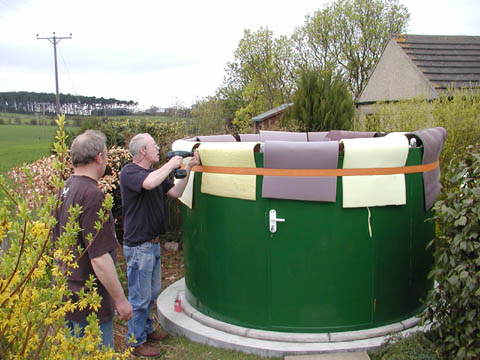

         foam protection around the rim. At all times the attention
         to detail was absolutely first class.
       |


       |


      |

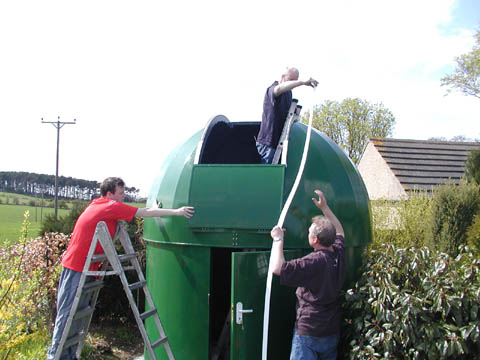

          With the dome halves installed, fit the runners for the
         sliding aperture.
       |


       |


      |
          And fix the whole thing down to the slab.
       |


       |


      |

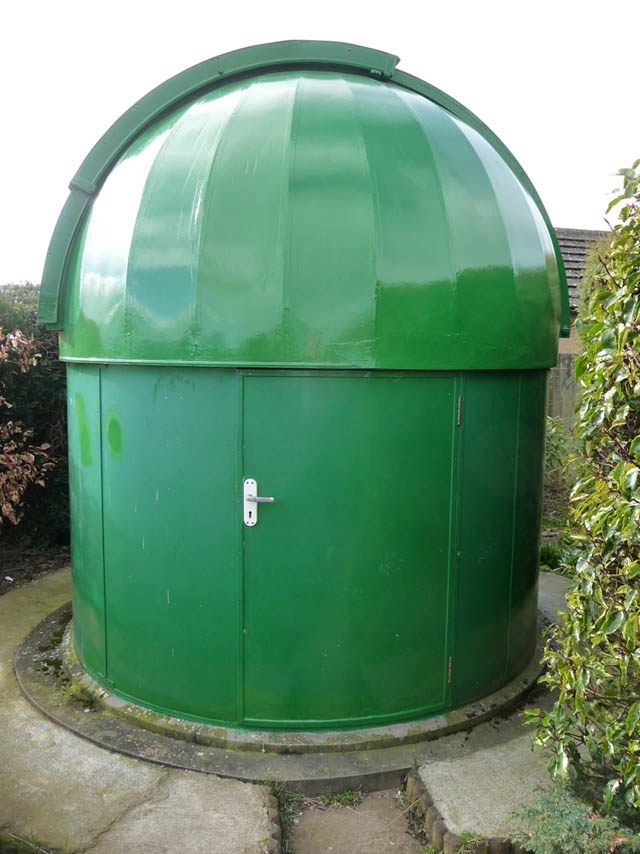

          Finished!! Now that the Dome is up I can determine the
         height needed for the pier. But for the moment I can observe
         with the tripod. Once the pier is installed I can fit a
         raised floor and carpeting - keep my tootsies (feet)
         warm!
       |


       |


      |
          Peace is restored. We were most fortunate in having a
         fine calm day for the installation. I can't praise the
         workmanship and standard of construction too highly. Quality
         with a capital 'Q'. Astronomydome definitely
         recommended!

         Postscript. Unfortunately a
         few years later they ceased trading. Don't know why, but a
         pity. The dome is still going strong after 15 years (but see
         lower down about some woodwork deterioration.)
       |


       |


      |
          Still more to do! First job, run mains power (and burglar
         alarm wire) from the observatory through the shrubbery and
         beside a path to the nearest access point. Then with a
         holiday approaching and the pier to be constructed, I just
         enjoyed observing for a few days. A glitch in the Gemini
         controller required a replacement unit, but this duly
         arrived from Hungary and all was well again.
       |




       |


      |
          I was away on holiday for a couple of weeks, but meantime
         the pier was progressing. Some time ago I had been given
         some 8" diameter stainless steel tube. So with a top plate
         and base design prepared, the pier was being manufactured
         while I was away. Ready for installation on my return, and a
         fine job, courtesy of H. Mullins (also sadly ceased trading
         in 2016). But it had to be bolted solidly to the block.

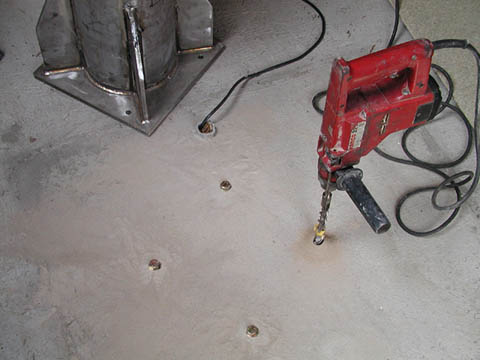

         Rawlbolts were used with 12 mm thread size, requiring 20
         mm holes in the concrete block. Four holes to match the
         holes in the pier base. Anybody who has drilled holes in
         concrete will know how tricky it is to get them exactly
         centred. So I had to be very careful, as the holes in the
         base were 13 mm dia, only allowing for small
         discrepancies.

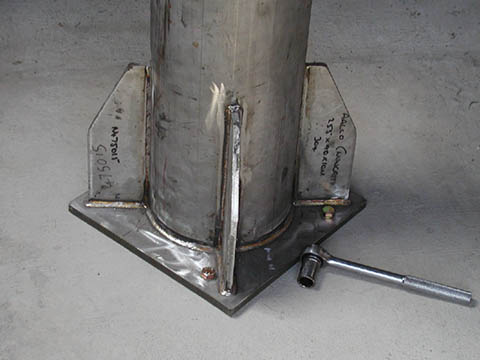

         But it fitted first time. Phew!! Then filled with around
         150Kg sand and gravel (I had plenty left over from the base
         construction) to further increase stability and minimise
         vibrations.
       |




       |


      |

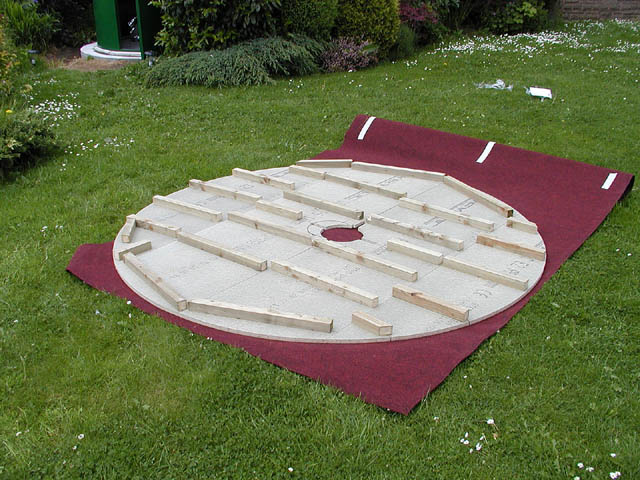

          A raised carpeted floor is nice to have. Much more
         attractive than bare concrete, warmer on the feet and
         elevates the viewing position slightly. It's much easier to
         fit a carpet when you can lay the floor on top of it!
       |


       |


      |
          The previous night I aligned the pier top plate with true

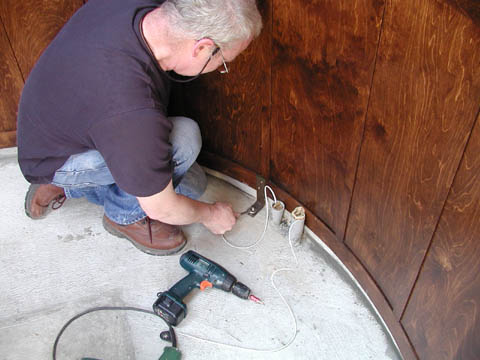

         North. So with the plate bolted to the pier, the pier
         painted, and the floor in place I could finally mount the

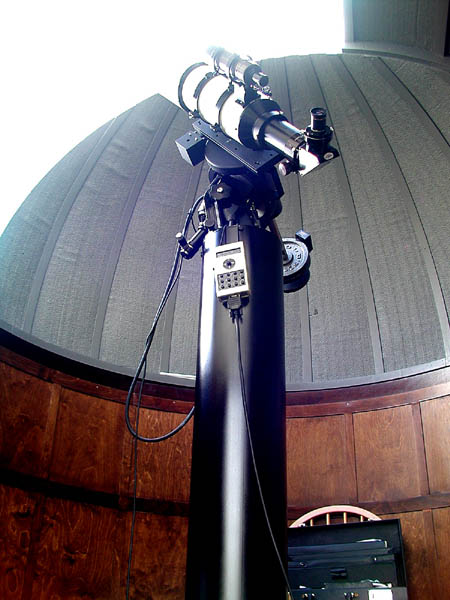

         Gemini, carrying the TMB tube. When the Maksutov tube
         arrives, I intend to mount both together side by side with a
         suitable carrying plate.
       |


       |


      |

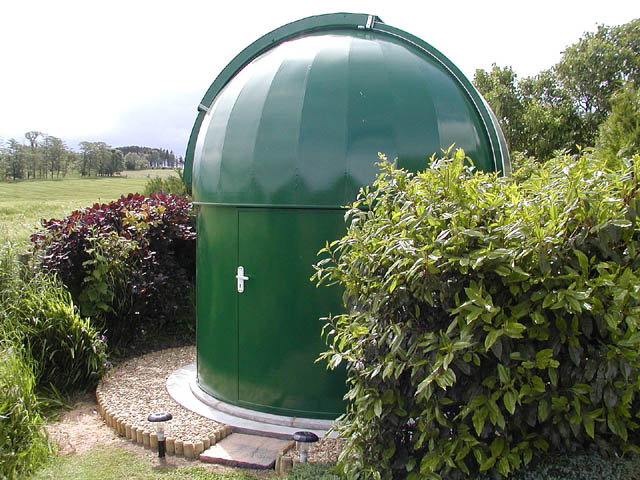

          A gravel path around the dome adds the final touch and
         improves access for maintenance and shutter operation.

         And there it is! 11th. June 2004. A bit over two months
         from start to finish. I'm undecided about a fitted table,
         but for the most part the labour is over, and now I can
         settle down to enjoying the Observatory.


       |


       |


      |
          Post Script. 21st. July 2004.

         Power points and work space. I finally decided to fit
         permanent shelves, one of them as a table, curved to match
         the dome wall.


       |


       |


      |
          And finally.... (well some things are never
         finished.)

         Later that Summer I laid a patio at the main garden
         entrance from the house (via a Conservatory) and a path to
         the Observatory. So I can get from my house to the
         Observatory without walking on the grass. And on cold winter
         nights, if I'm taking a longish set of images it's easy to
         retreat to the warmth of the house!

         The following Summer (2005) I also laid slabs on a small
         raised area, previously grassed. This makes a nice observing
         platform for visiting astronomers to set up their own
         telescopes. (Once they move the bird bath!)
       |


       |


      |
          After some years of using my laptop for imaging, as it
         became a little less reliable and needed extras to run
         modern USB 2 equipment, I replaced it in March 2010 with a
         mini computer, utilising a spare monitor. A nice permanent
         installation (my laptop is still eminently usable for star
         parties etc.) At night of course I have a red film over the
         screen (inset).
       |


       |


      |

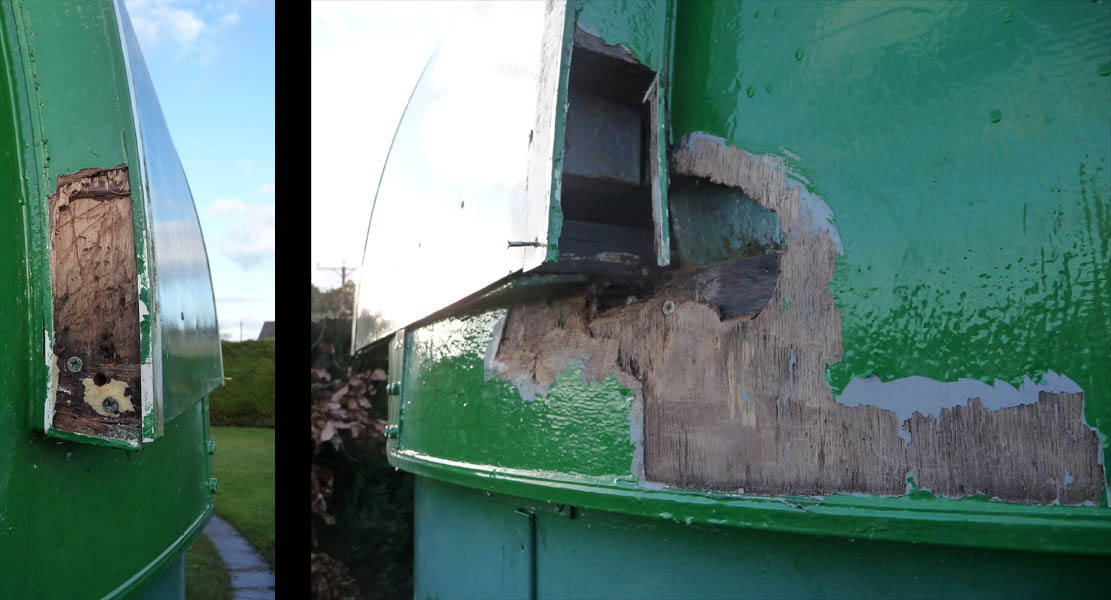

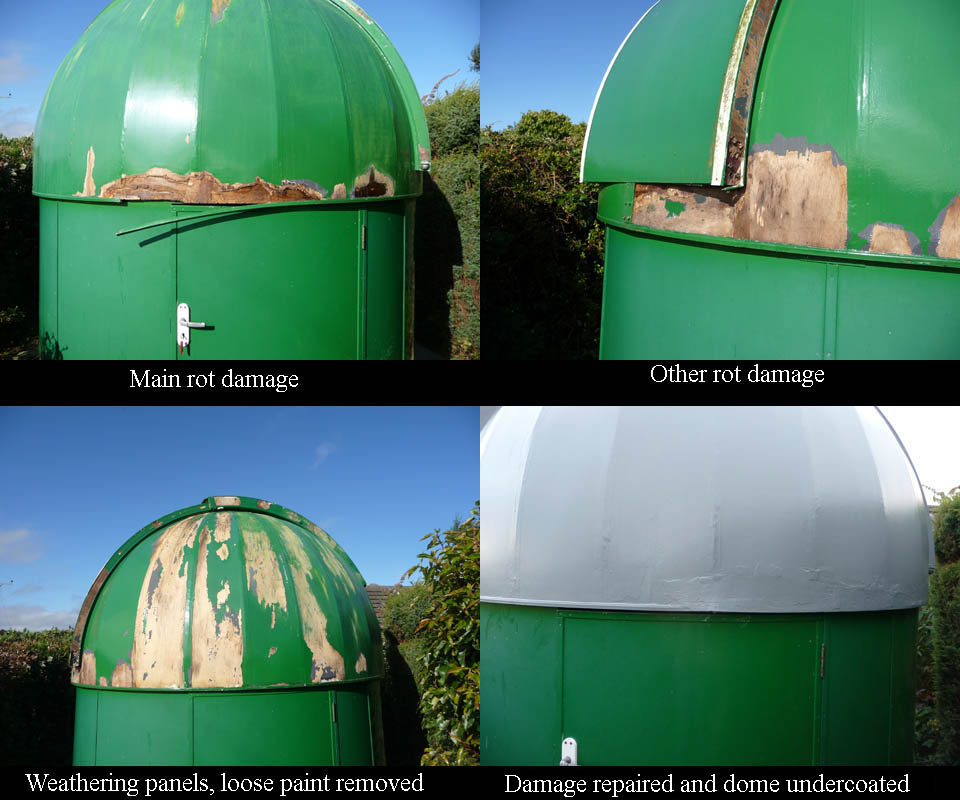

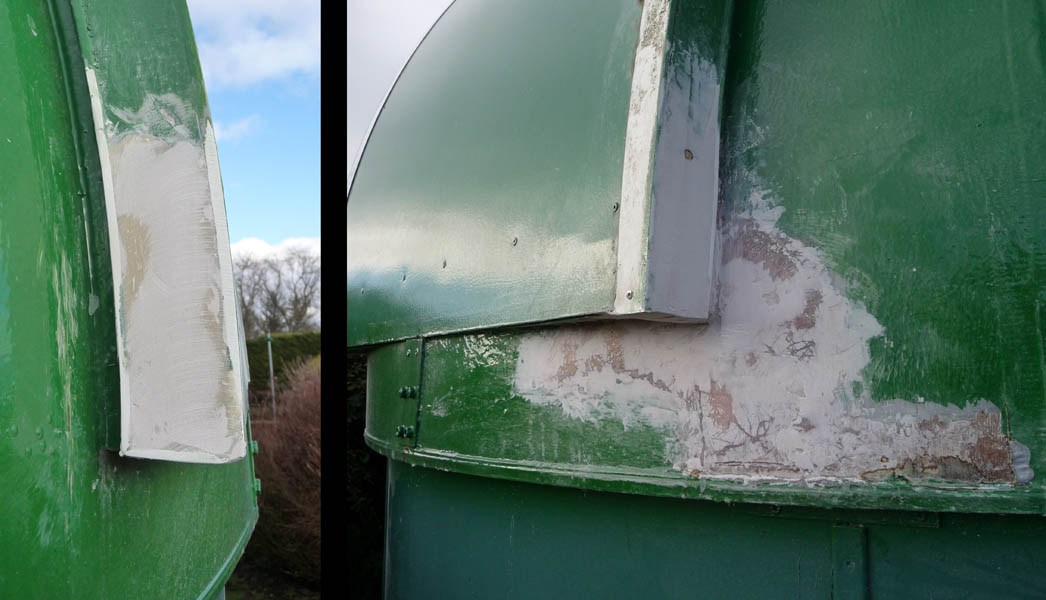

         Around 2011 a bit of rot appeared on the dome above the
         door. A small amount of patching seemed to do the trick. But
         it reappeared with a vengeance in 2013, quite extensive and
         other areas also affected. Weathering of the paint also was
         greater than usual, so although it had been repainted
         before, major work was necessary. Strangely in some areas
         where water was lying under paint there was no

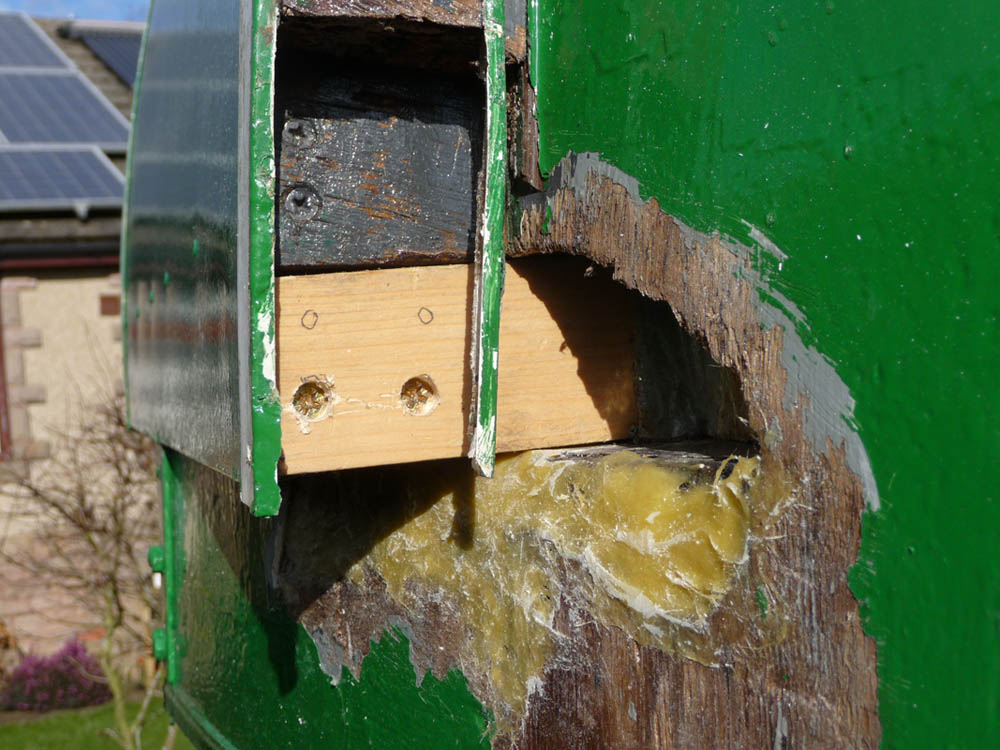

         deterioration, but this time after removing the damaged wood
         I gave all bare areas a thorough soaking with preservative

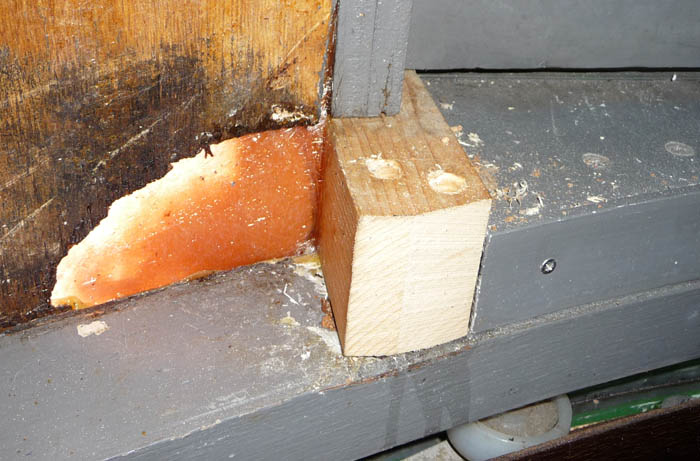

         before starting repairs. The worst affected sections were

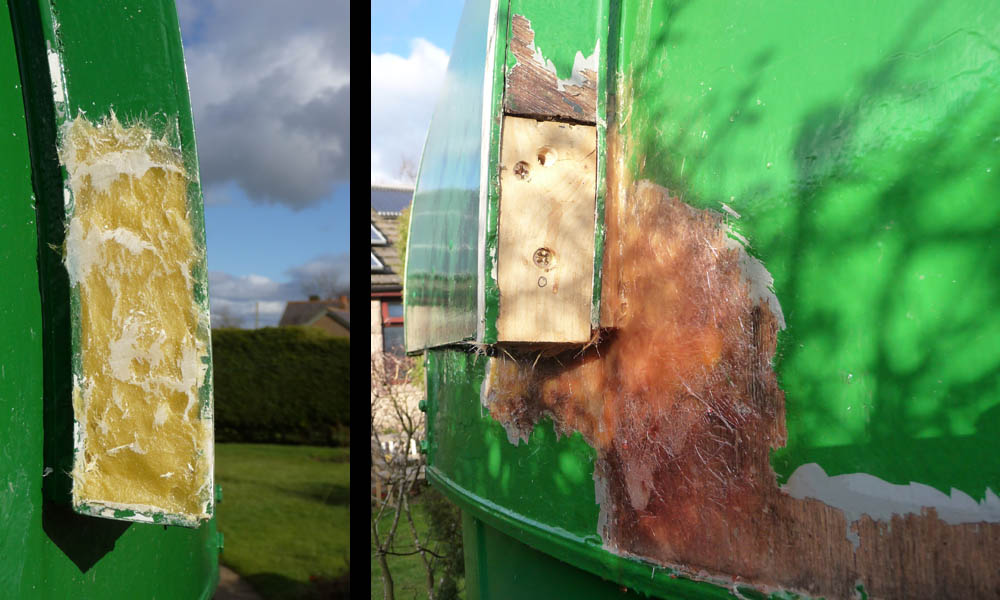

         reinforced with fibreglass mat before filling and
         undercoating.
       |


       |


      |

         There were a couple of small areas also slightly damaged at
         the bottom and to the left of the door, but these were

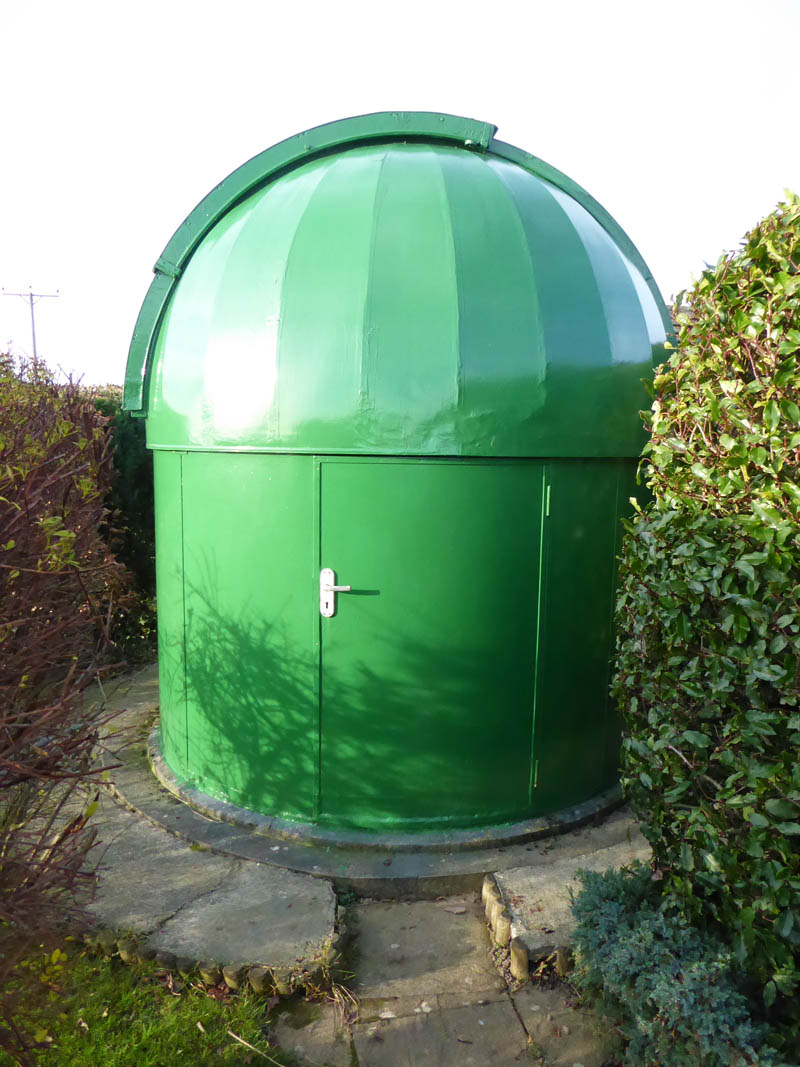

         easily fixed. Then all affected areas gloss painted.
         Hopefully the repairs will stand the test of time, but I'll
         have to keep a closer eye on the paintwork - clearly ingress
         of water through cracks in the paint was the prime cause of
         the damage. Presumably flexing of the dome combined with
         temperature variations is the root cause of the cracking - I
         might need to repaint every year. Unfortunately as mentioned
         above the manufacturers are no longer in business, and if a
         replacement becomes necessary most commercial offerings
         around this size are lower and smaller. Fingers crossed!

         A couple of years previously I replaced the gravel path
         with concrete - I found that weeds took hold despite the
         presence of a membrane, and clearing up after trimming the
         shrubs was a nightmare. Also walking round the observatory
         late at night was rather noisy!
       |


       |


      |
          More Damage
         :-(

         In February 2016 I was showing a friend the Observatory
         and partly closed the roof to keep out a slight shower. But
         a gust of wind caught the shutter and forced it off the ball
         catch which holds it in the half open position. It crashed
         down on the open side buffers which had evidenced some rot
         in 2013, particularly the one to the right. They were both
         dislodged although held the shutter from moving further. The
         buffer on the right came away completely, exposing serious
         rot damage. This was the main load bearing spar for the

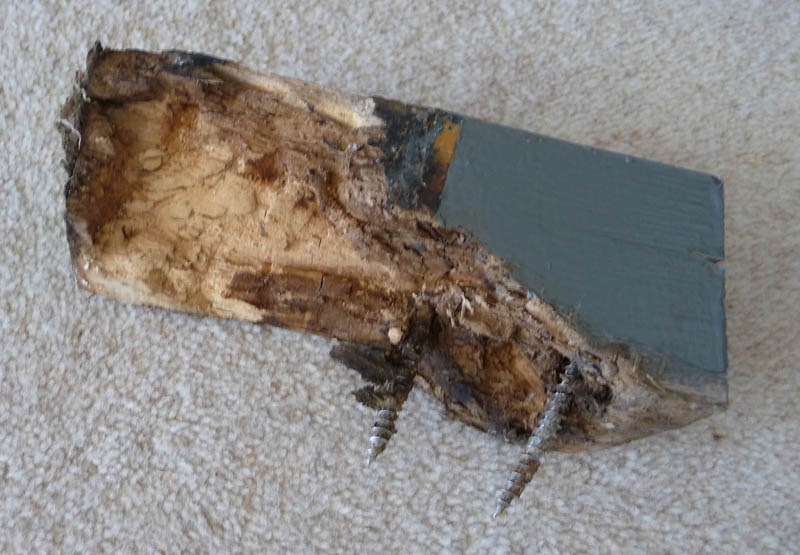

         buffer!
       |


       |


      |
          The rot had also affected the interior section that the
         spar was screwed to, so that had to be repaired. And there
         was extensive damage in the general area. Not so bad for the
         other buffer, the underlying wood was weak but intact, and I
         decided to leave it alone - I may need to dig deeper in a
         year or two! The main spar which was so badly rotted had to
         be replaced of course, and a further external section also
         needed replacing along with a substantial area of plywood
         skinning.
       |


       |


      |








         So the rotted sections were cut out and the remaining
         wood treated with preservative and hardener. The main frame
         was built up to the original form with fibreglass paste to
         take a replacement spar. A further block of wood was then
         screwed to that to accept the buffer (the empty hole was a
         mistake - when I came to fit the section I realised the hole
         was too high - oops!)

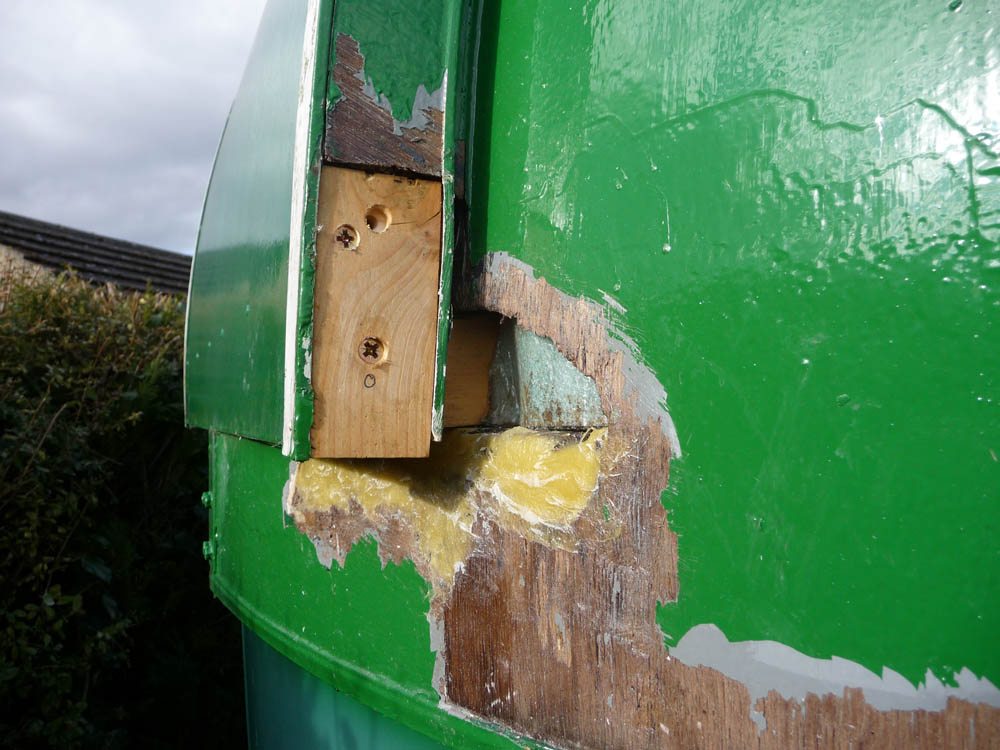

         This photo shows the inner end of the spar where it is
         screwed to the main frame. The orange coloured stuff is the
         fibreglass later applied externally.




       |








       |


      |

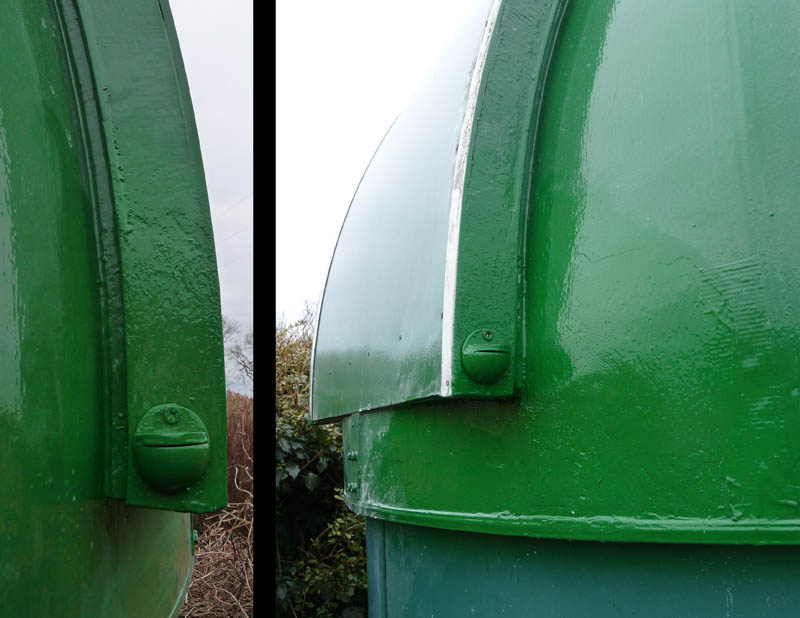

          This shows the finished fibreglassing - a double layer of
         mat replaced the missing plywood skinning and paste built it
         up to profile as well as strengthening the fixing on the
         less damaged side. A small piece of wood also helped to fill
         a space where old wood was removed.



         Then resin filler was used to finish profiling the
         repair.
       |




       |


      |

       |


       |


      |
          Undercoat then gloss to finish off and the buffers
         refitted. Not the prettiest of jobs - I was working against
         the clock to make use of a few days of fine weather (full
         Moon so didn't miss the unuseable Observatory too much!), it
         was cold so slower setting and drying and some bits got
         stuck in the paint - I'll tidy that up another time. But
         back in business. The areas at the bottom and left of the
         door, mentioned in the previous repairs in 2013, also need
         attention again, but can wait until warmer dryer
         weather!
       |


       |

 In Spring 2017 when I fitted a motor to the dome, more damage
became evident. See lower down on the Motorising
page.
So that's the rim repaired, but the next step is out with the
sander and paint hopefully to sort the cracked areas. And the bottom
edge of the door still needs fixing. But I'm determined to keep the
Observatory going - although there are suitable replacements
available, it would be an awful lot of work and fair chunk of
money!
A few weeks later. The door still needs attention, and despite a
quick coat of gloss, water was still getting in through cracks.
However, some serious work with a disc sander then undercoat and
gloss has cured the dome leaks afaik. Certainly after 24 hours of
rain in July it was still dry inside. Phew!! In future I'll have to
keep a close eye on the condition of the paint and have the sander
and paint ready ;-)
